Central Ontario

Bowmanville to East GTA Power Line

Hydro One is investing in new infrastructure in the region to meet growing electricity needs and ensure safe and reliable power for your community.

Current project phase: Class Environmental Assessment (EA) ongoing

Expected completion date: 2032

Community open houses Contact
Arial view of Sudbury's Bell Park
TX lines

Building a stronger grid for Ontario's future

Project overview

Ontario's long-term demand for electricity is increasing, as is the investment required to strengthen the electricity system. The Independent Electricity System Operator (IESO) projects that demand in the East Greater Toronto Area (GTA) could rise faster than in other parts of the province. As an Ontario-based company, Hydro One continues to build new transmission lines to meet the growth in demand and is planning the proposed Bowmanville to East GTA Power Line. The project includes a 45-kilometre double-circuit 500-kilovolt transmission line from the Bowmanville Switching Station in Clarington to Cherrywood Transformer Station in Pickering. To support this work, a Class Environmental Assessment (EA) has been initiated. The proposed project will help meet the regional need for more electricity, improve resiliency and reliability of the grid and support long-term growth.

Partnership with purpose

Building as partners

Through Hydro One's industry-leading 50-50 First Nation Equity Partnership Model, First Nation partners will have the opportunity to invest in a 50 per cent equity ownership stake in the transmission line component of this project.

Together, we build a more self-reliant and secure electricity system to power growth in central Ontario.

Learn more
Indigenous transmission twoer artwork

Visit an open house near you

Current open houses

Ajax

Tuesday, April 14, 2026

4 to 8 p.m.

McLean Community Centre, 95 Magill Dr

Get directions

Solina

Wednesday, April 15, 2026

4 to 8 p.m.

Solina Community Hall, 1964 Concession Road 6

Get directions

Whitby

Thursday, April 23, 2026

4 to 8 p.m.

Brooklin Community Centre, 45 Cassels Rd E

Get directions

See the project study area

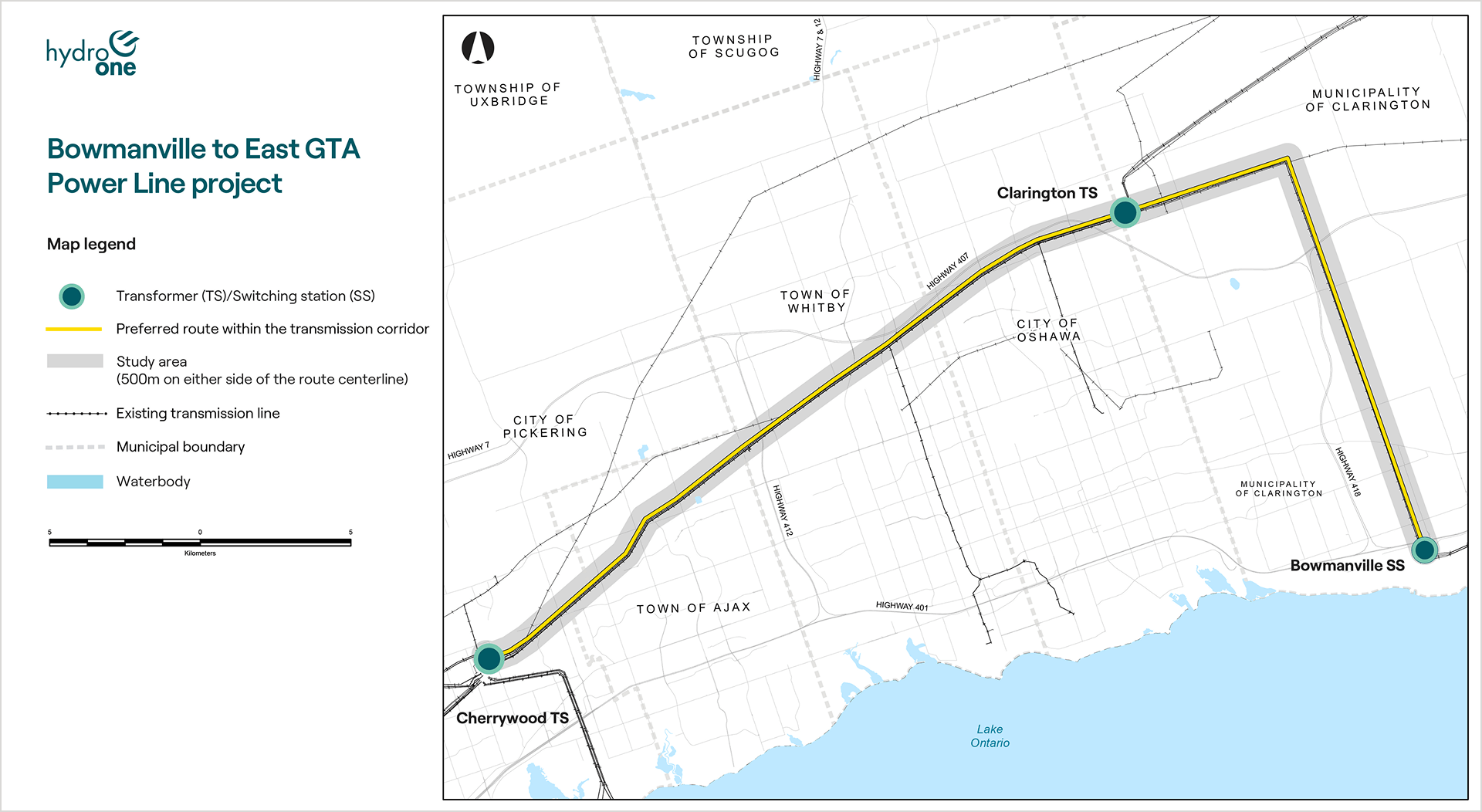

Project map

Hydro One prioritizes the use of existing transmission corridors wherever possible. As part of the Class EA process, we have identified a single viable route option for the proposed transmission line within an existing corridor. This route will be further studied by gathering environmental and technical data, along with input from Indigenous communities, community members, elected officials, interest groups and businesses.

Your feedback is important. We encourage you to view our interactive map and share your input.

View interactive map Download map (PDF)
Project map

See what's coming

Anticipated project schedule

Spring 2026
Notice of Commencement and community open house #1
Spring 2026
Environmental field studies and research to support the Class EA
Early 2027
Community open house #2
Spring 2027
Draft Environmental Study Report (ESR) for 30-day public comment period
Fall 2027
Finalize ESR to complete the Class EA
2028
Complete detailed design and obtain permits and approvals including Leave to Construct (Section 92) from the Ontario Energy Board
2029
Proposed construction start
2032
Line energized
*Dates are subject to change.
